The product is on the front page; this page is the detail behind it — what the FX-45 package contains, and how a production slot is held.
In the box
Everything the FX-45 package supplies.
FX-45 is packaged by USP&E around the Torino-built TG20 B7/8 UG. The standard scope below travels as one package; nothing in it is a project variable.
- Gas turbine, reduction gear and generator on a common plinth
- Acoustic enclosures with ventilation, lighting, fire and gas detection, CO2 and dry powder protection
- Air inlet system: filter house, transition, silencer and duct to the compressor plenum
- Exhaust gas duct and expansion joint to the stack interface
- Lube oil, cooling, hydraulic and trip oil systems
- Fuel gas conditioning, metering and valve train
- Package control system, LV MCC, UPS and DC supplies
- Cabling, earthing, lightning protection, access platforms, stairs and handrails
Priced separately, when ordered
- SCR
- CO oxidation catalyst
- Spares and tooling
- LTSA and O&M
- Inlet chilling
Project scope, not supplied
- Exhaust stack
- SCR (unless ordered)
- Electrical building
- Balance of plant
- Civil works
- Grid interconnection
Exhaust stack and SCR are excluded from the FX-45 package price. SCR is quoted separately when required for the selected NOx target.
Built out

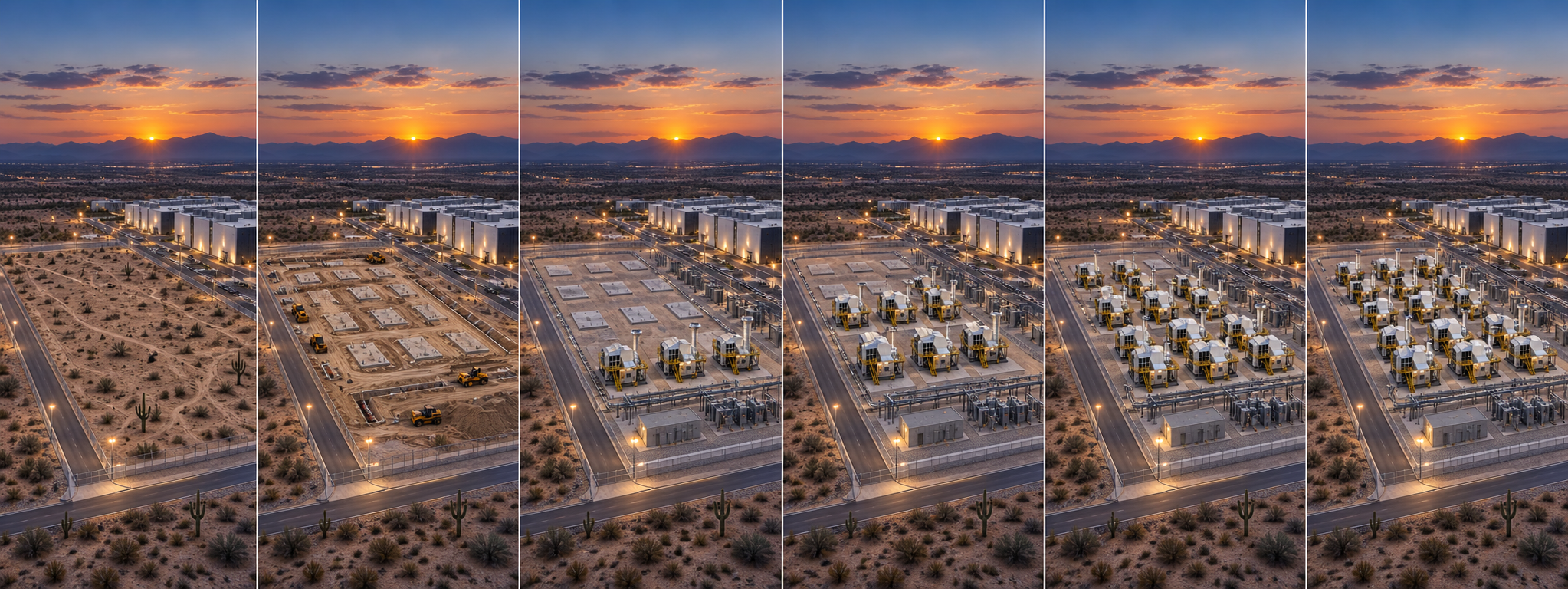

Brownfield to twenty installed modules in six visible phases.
Arizona 20 × FX-45 reference campus · high-tech hyperscale data center

100% of the 20-unit reference fleet installed
- Install the final six FX-45 packages
- Commission all twenty generation islands
- Activate long-term outage sequencing
- Operate with local and regional spares support
Baseline fuel: Pipeline natural gas, including regasified LNG delivered through the pipeline. Three installations in 2028, five in 2029, six in 2030 and six in 2031.
How a slot is held
First come, first served on receipt of reservation deposit.
Three units ship by 3Q 2028, five spread through 2029, then six per year (one every two months) from 2030 onward.
A signed Slot Reservation Agreement and cleared 30% deposit on the minimum 15-package order are required before production slots are secured.
Delivery dates become contractually firm in the Slot Reservation Agreement on receipt of the reservation deposit. Until a slot is reserved it remains open to other buyers.
